How We Successfully Reached 13 Route Locations in 4 Weeks and Across 1,640 miles

Jun 23, 2021 | News

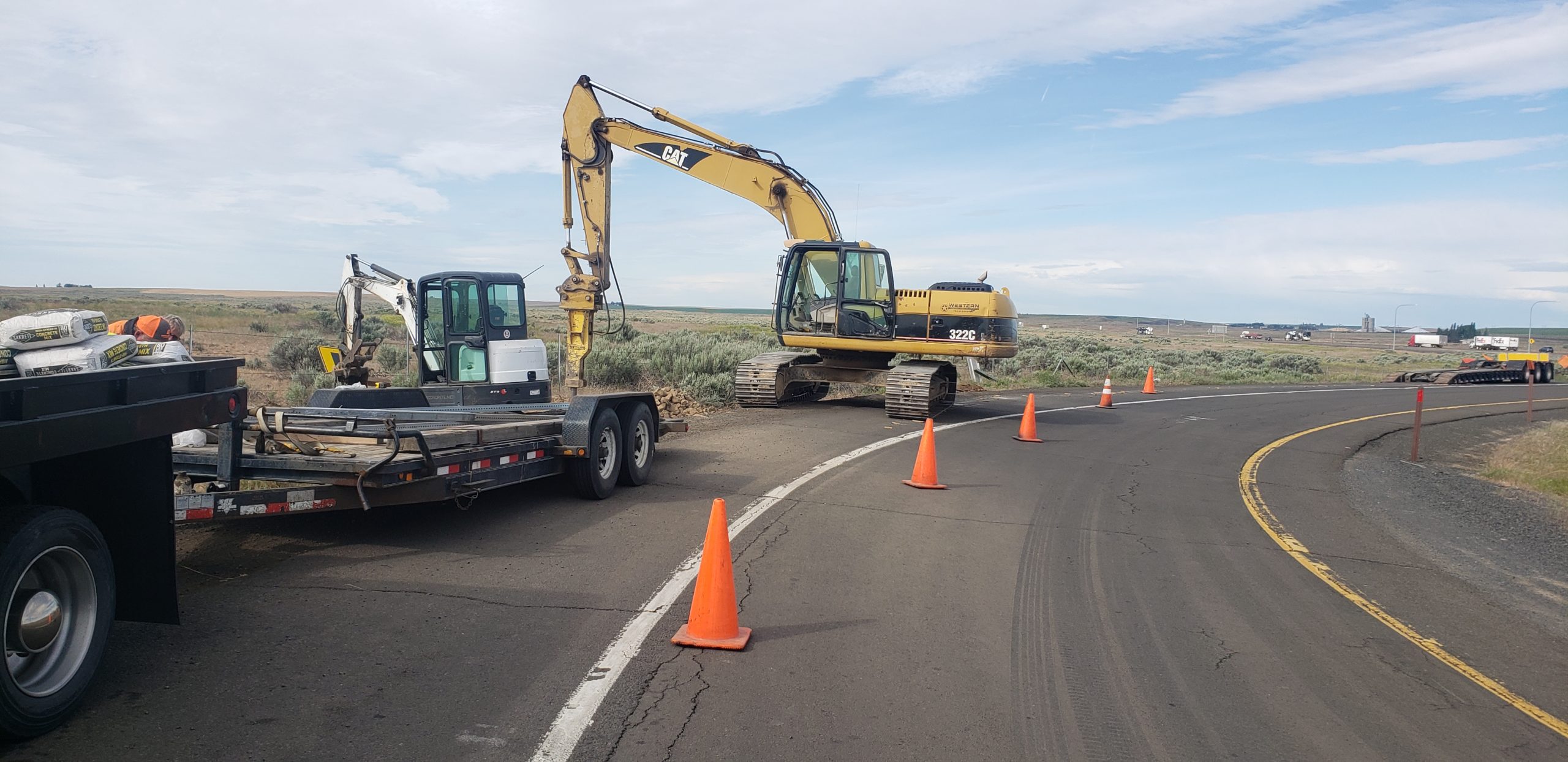

Our latest route improvement project, Blue Hills, had us executing route improvements across 13 different locations. To give you a better idea of what this project looked like, here’s an overview from one of our team members on how the project went down.

The Project
Our customer approached us to execute route improvements along the delivery route from the Port of Longview, WA to the project site in Central, SK.
The Scope
Included only 7 locations along the route, but due to HWY construction along the route, WSDOT and MTDOT rerouted the deliveries, causing the need for an additional 6 – 13 total improvement locations.
The Challenges
We were up against time, specifically 4 weeks, to accomplish:
  • Approved Permitting from WSDOT and MTDOT
  • Locate and onboard 3 approved local contractors to do the work
  • Coordinate with the SK Ministry of Hwys to perform the sign relocations in SK
  • Coordinate with SK Power to have a Light Pole temporarily removed
  • Coordination with an approved contract to handle a temporary removal of a private utility pole in Plentywood, MT

Originally planning for 7 locations, we adjusted, pivoted, and adapted to the tasks at hand and completed the project 1,640 miles later. More innovation, less risk, always.

Newsletter Signup

Recent Posts

What It Really Takes to Move a Main Power Transformer

What It Really Takes to Move a Main Power Transformer

The transformer is the one component your project can't afford to lose. Getting it there is a project of its own. Every power project has components that are big, expensive, and hard to move. The main power transformer is the one that can stop the whole project. It's...

read more
What It Really Takes to Repower a Wind Farm

What It Really Takes to Repower a Wind Farm

By the time most operators decide to repower, the case is already clear. The turbines are aging, the technology has moved on, and the site still holds the two things that are hardest to secure in wind energy: an approved permit and a live grid connection. Repowering...

read more
